In brief
A slope and difficult terrain do not rule out a residence — they change the question from “whether” to “how much”. Before I say it can be done, I want to know three things: where the water runs on this plot, whether the slope itself will hold once I add the weight of a house and a cut, and how deep along the fall the load-bearing ground sits. The footings, the retaining walls and the drainage come out of those answers, and it is those, not the house itself, that move the budget. Most of it has to be on the table before the architect draws a single line. And a well-tamed slope often gives you the very thing you build here for: the view and a natural split of the house across two levels.
A slope is work to be costed
Let me start with the mindset, because everything follows from it. A slope is not a defect in a plot. It is a task — harder than a flat rectangle near town, but one you can put numbers on. Firms turn these plots down not because “it cannot be done”. They turn them down because the risk and the cost have to be worked out far more carefully than on a flat site, and not everyone wants to take that on. I run the numbers on these plots, because the views worth building for in southern Poland rarely sit on level ground.
A gradient changes the rules from the first measurement. On a flat plot I set the level of the house from the highest point of ground around the building. On a clearly sloping plot that method simply stops making sense; there is no single “around”, there is an uphill and a downhill side, sometimes a full storey apart. It is a small thing, but it makes the point well: on a slope you cannot assume anything by routine. Every item has to be worked out again, for this particular fall.
So before I promise anything, I go to the plot with three questions: about the water, about the stability of the slope and about the ground. Everything else — the design, the schedule, the price — follows from the answers.
First I ask where the water goes
On a slope water has a direction and a purpose: to run down. My job is to make sure that at the end of that run it does not find the joint where the footing meets the wall.
Let me start with what you cannot see. The place where water gets into a house is not the floor — it is the layer beneath it, a hand’s width lower, where the damp-proofing sits and the walls begin. Water that reaches it has no way to dry out of the insulation; it stays, and in time it turns into damp and mould. On flat ground you keep it out with the fall of the terrain away from the walls, a gravel margin around the house and a floor level raised above grade. On a slope that is not enough, because the water has a direction: it comes down from above and hits the house on the uphill side.
And here is the heart of the difference. On a flat plot, where the ground calls for it, a ring drain takes water away all around the building. On a slope that ring stays, but on its own it is not enough, because groundwater runs down through the layers from above and piles up on the inflow side like water behind a badly placed dam. So higher up, across the slope, you run a second drain — an intercepting one. Its only job is to catch the water and lead it off to the side before it ever reaches the footings. I cut it off before it becomes a problem.
The water you catch still has to go somewhere, and on a slope that is often harder than collecting it. Ideally you lead it downhill by gravity, into a storm drain or a ditch, with the permits that requires. A soakaway is tempting then — just put the water back into the ground on the plot. On flat, permeable ground it can be a good solution. On a slope it can be a trap, because the water you release can saturate the hillside and set it moving on its own; so a soakaway is not my call but the geologist’s, on the strength of the tests. The water level, by the way, is not a single number; it changes through the year, so one reading in late summer can be reassuring for no good reason (late summer is usually the low point for the water, so a single reading from then is easily taken for granted). What counts is the highest level you can expect here.
Sometimes the water stands under pressure and no drain will lower it; then you do not lead it away but make the below-ground part watertight, able to take the push. That is a different class of work, closer to what I described with a pool set below a high water table. One thing is common to all these cases: you do not ignore the water. Ignored, it does not disappear. It comes back with the first heavy rain.
Will the slope hold
The second question is one you never ask on a flat plot: will the ground I am to build on hold itself once I load it and disturb it.
A slope stands as long as the friction in the ground is greater than what pulls the mass downhill. Water spoils both sides of that balance at once. Soaked ground is heavier, so it pulls down harder. And water between the grains pushes them apart and lowers the friction. That is why a slope that stood quietly for generations can move after one wet spring, once too much water has soaked into it. Landslides rarely have a single cause; it is usually several small things at once, and water is the one that tips the scale.
Building adds two more. The weight of a house at the top of a slope presses on ground that is already under strain. And a cut at the foot — for a garage driven into the hillside, or a lower storey — removes the ground that was holding the mass above it like a prop. Undercut it without support and you can set moving what stood for years. Sometimes at once, sometimes after the first heavy rain. Even the greenery matters: tree roots act like reinforcement on a slope, so I am careful about clearing them.
That is why on a slope I have the ground tested more densely and more deeply than on flat land. A flat plot tends to be the same everywhere; a slope can change its layer profile every few metres down the fall, so two boreholes in the corners settle nothing. Exactly how many, I will not say in advance; it depends on the layout and on what the first ones show. There are also areas formally marked as at risk of landslides, listed in public registers; such a plot automatically means complex ground conditions, and the building itself usually lands in the highest geotechnical category. A separate, wider set of geological studies comes in then — ones that have to work out the stability outright and design the drainage. In fairness: no entry in the register does not mean it is safe, because those maps do not cover the whole country. So I take neither the seller’s word nor the map on trust. I trust what the boreholes show.
Where to check the rest of a plot’s parameters — the zoning plan, utilities, access, boundaries — I wrote up separately, in the piece on vetting a plot for a residence. Here I deal only with what the fall itself does to a house.

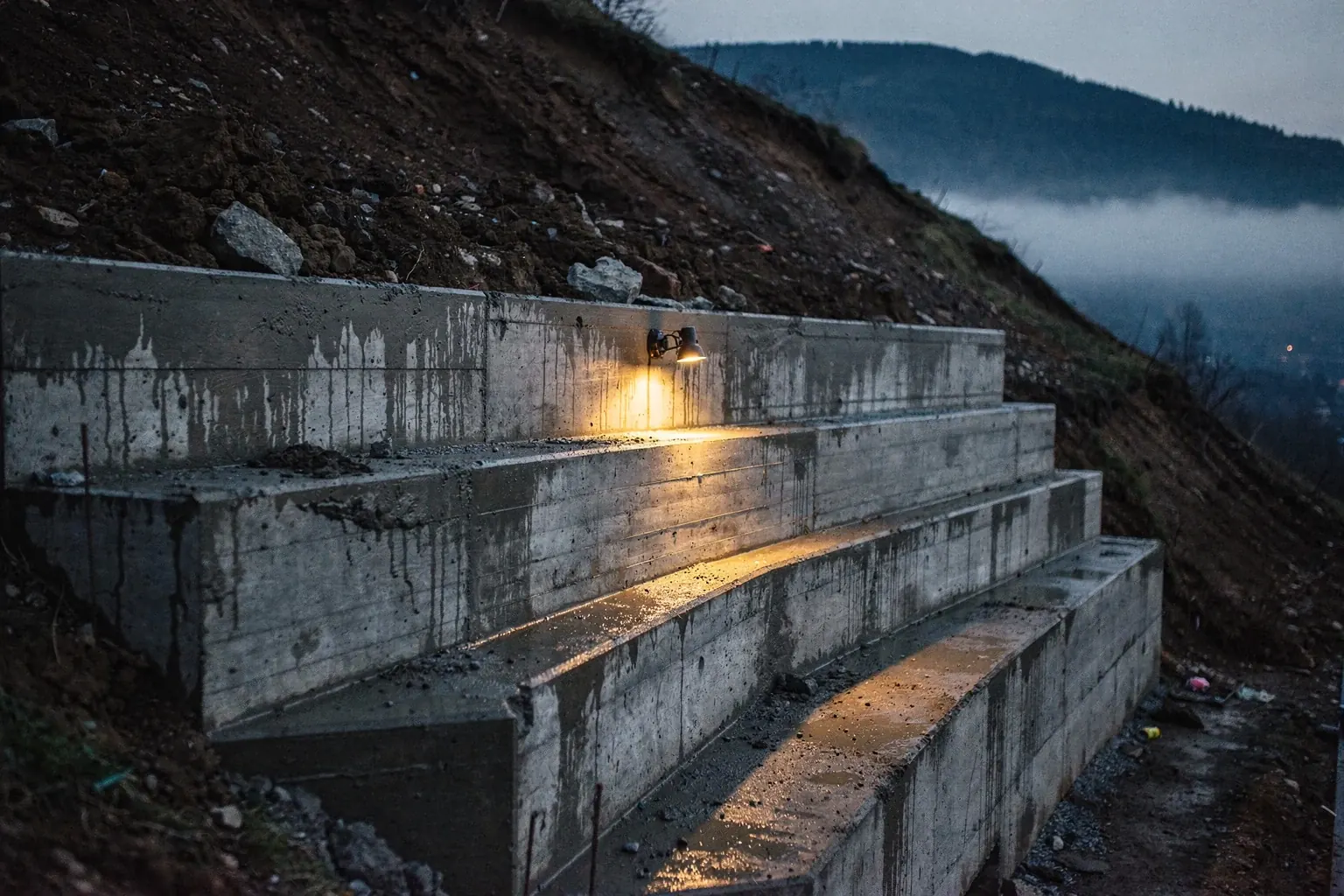

The footing steps down, the wall holds it
The third question is: how deep along the fall does the ground sit that will carry the house. Because on a gradient the footing does not rest on one level.
It is run in steps. Each length of footing has to reach a firm depth into load-bearing ground, below the frost line, measured from the terrain that happens to lie above it. Since the ground drops, each next step of the footing has to go lower to keep that reserve of depth. The steps cannot be as steep as you like; too sharp a step concentrates stress and the footing can crack there, so they are kept gentle. The steeper the slope, the more of these steps, and with a really sharp gradient you move to piles or a slab — and the slope itself still has to be secured separately. It is one of those things that do not exist on a visualisation and decide the price under the ground.
Where the house goes into the slope, its wall on the uphill side stops being an ordinary wall. The ground pushes on it, so it works as a retaining wall and is calculated like a basement wall: for the push, not just for the load from above. To that you add insulation and a drainage layer right against it, so the water push does not build up. The drain relieves that insulation but does not replace it; they are two different things and both have to be done.
And then the retaining walls — the item most often underpriced, because from a distance it looks innocent. Here you have to grasp one thing: a wall’s height does not track its price evenly. The earth pressure is lowest at the top of the wall and greatest at its base — and the taller the wall, the faster the total of that pressure grows, much faster than the height itself. Double the height and the force at the base rises several times over. That is why a wall that looks like a plinth on a drawing can be the single most expensive element on the plot. To that you add what you cannot see: the wall’s own footing, tucked below the frost line, and on weak ground its reinforcement too; and the drainage behind the wall, without which water piles up at the back and adds push to push. That drain behind the wall is not optional. Without it the wall sooner or later bulges or slides, and then the repair costs many times more than doing it right the first time.
There are several forms, matched to the situation. A reinforced-concrete wall holds with a slim face resting on a wide footing, with the backfill sitting on it and helping to hold it down — but that footing needs room. Gabions, cages filled with stone, let water straight through, so the water push does not build up behind them the way it does behind a solid wall, though they take up more space and still need proper drainage. Sometimes there is no room for a footing at all, because the wall stands on the boundary — then the engineer turns to solutions that do not need a wide footing: anchors, micropiles or a pile palisade. Which variant it is, the structural engineer decides for the particular slope. And one practical point: a retaining wall holding a hillside is not a fence. It is a structure with a structural design and formalities — often a building permit — one that on top of everything must not worsen the water runoff onto the neighbour’s land.
Working on a gradient
There is one thing you think about last, and on a slope it can decide half your troubles: whether the build can be physically serviced at all.
Heavy equipment does not like a gradient. A concrete truck with a full drum weighs over thirty tonnes and needs a hard access road; the concrete pump and the crane set up on outriggers, and those have to stand on level, load-bearing ground. On a gradient there usually is no such platform — you have to make one first: harden it, level it, sometimes lay road plates. The pump operator has the right to refuse to work if he sees the machine will stand crooked or in mud, and he is right to.
Then there is the earth. A cut driven into a slope yields far more of it than a cut on flat ground; some goes to level the terrain on the other side of the house, the surplus has to be carted off. A spoil heap on a gradient will not hold itself — it can slide, block the access or bear down on the edge of the excavation, so you plan the room for spoil in advance. The excavation on a slope needs its walls secured too, and left open it will not stand for long, because the first downpour washes it out. So the work is sequenced so that what is done higher up does not disturb what is already done below. None of it is unbuildable. It all just has to be foreseen before the price, not discovered on site.
When the slope becomes the point
I have written a lot about the trouble, so let me say now what you go into it for. Because a slope used well gives you something a flat plot never will.
The same fall that forces a stepped footing lets you set the house into the slope. Down below, driven into the hillside, goes what is meant to be closed and cool anyway — the garage, the plant room, a wine store, rooms with no windows. Above them, already at the level of the upper garden, sits the living space, opening straight onto the view. One house, and two ground floors on two levels of terrain, each with its own way out. On a flat plot you would have to stack that upward; here it lays itself out along the fall. The roof of that lower storey often becomes the terrace of the upper one. Such a house does not stand on the slope — it sits in it.
There is a catch in this, and I say it plainly, because it ties the whole piece together. The cut that gives you the lower storey and the view is exactly the same cut that undercuts the slope. Whether the slope turns out an asset or a landslide is not decided by luck. It is decided by a retaining wall sized for the right push, drainage led where it belongs, and a sequence of works that does not disturb the ground before there is something to hold it. With a house like this, what matters to me most is that the part under the ground is dull and predictable.
When a slope is not worth it
Are there slopes where it cannot be done? Truly rarely. Engineering copes with water, weak ground and a fair gradient — the question almost never is “whether”, but “how much does it cost” and “does it make sense”. A real limit is an active landslide: ground that is still moving is one of the few cases where I say plainly it is better to let it go.
There are, though, slopes where building is not worth it. When the special footings, the tall retaining walls and the fight with water climb to a level where, for the same money, you buy a quieter site next door and the same view — I say so plainly, with the costs written out on the table. The decision stays with you. Sometimes the particular spot is worth it, because there simply is no second view like it. And sometimes, once the walls are added up, the sentiment lets go on its own.
One caveat, so we understand each other: the surveys and a sound design take off most of the risk, not all of it. A slope can surprise you even after a thorough investigation — with a local seep of water, a layer that was not in the borehole next to it. I promise an honest read of the ground and a costing of the known risks before I name a price, with the margin of uncertainty shown where it remains. That there is nothing left under the hillside to discover, no one who has really built on slopes will honestly promise you.
What I check before I say yes
This is my standing set for a plot on a slope. The findings then go into the feasibility study my price rests on; I do not sign any figure without costing this whole list.
- Water on the slope — where it comes from, how high it reaches through the year, whether it can be led off downhill by gravity, whether an intercepting drain above the house is needed.
- Slope stability — whether the ground will carry the weight of the house and a cut at the foot; whether the plot lies in an area at risk of landslides.
- Ground along the fall — boreholes denser and deeper than on flat land, because the profile changes down the slope; the depth of load-bearing ground for a stepped footing.
- Retaining walls — where, how tall, for what push and with what drainage behind them; whether there is room for a footing or anchors are needed.
- Foundations — stepped footing, slab or piles; walls set against the slope calculated and waterproofed like basement walls.
- Site — access for heavy equipment, room for the pump and crane outriggers, the cut-and-fill balance and spoil removal, the order of works on the gradient.
How the work itself goes from there — from the first conversation to the settlement model — is a question to ask directly; I have gathered those questions in the Questions section.
Frequently asked questions
Can a house be built on a slope at all?
Almost always. Water, weak ground and a gradient are tasks for engineering, not dead ends — the question is what solving them costs, not whether it is possible. The exception is genuinely landslide-prone ground that is still moving; there I will advise against building outright. Beyond that it comes down to arithmetic: whether the result on this particular plot is worth what has to go into the footings and walls.
What raises the cost of building on a slope the most?
Usually not the house itself, but what holds it and drains it: retaining walls, special foundations and drainage. The building can be a smaller part of the bill than the slope beneath it. The wall is treacherous here, because its cost rises much faster than its height — every extra metre is disproportionately more structure. On top of that come earthworks you do not have on flat ground: platforms for the equipment, carting off the surplus soil, securing the excavation.
Why does water matter more on a slope than on a flat plot?
Because it has direction and momentum. On flat ground water mostly soaks in where it falls; on a slope it runs down from above and hits the house on the uphill side, piling up in front of it. The same water that saturates the ground also lowers its stability. That is why on a slope drainage is not an add-on to the design — it is part of it, as much as the footings.
Is a house built into a slope safe in the long run?
Yes, if the engineering under it is done for this particular slope. The walls set against the ground are calculated for the push and waterproofed as in a basement, the slope is secured with a wall sized for the right force, and the water is led away from the footings. The house is not safe “just because” — it is safe because what acts on it was worked out before the first excavator arrived.
